Technical Data  High-speed lifters  LIFT MASTER  Handling

Checking the item upon arrival/Transporting/Installation

This section describes the general handling of LIFT MASTER.

For details, please refer to the instruction manual included with the product.

Inspection upon Receipt of Product

When you receive the product, check that:
If you have any problems or questions, please contact the store where you purchased the product.

  • ・Check the nameplate to verify the model number (1), manufacturing number (2), and drawing number (3) match the requested product (see Fig. 1).
  • ・No parts were damaged during transport.
  • ・No screws or nuts are loose.

Reading the nameplate

(Fig. 1)Reading the nameplate

Include the model number (1), manufacturing number (2), and drawing number (3) when contacting Tsubaki with any problems or questions.

Mounting

1. Cautions for installation

Warning
  • ・Be sure to install the Lift Master under the specified operating environment standards.
  • ・Be sure to install the Lift Master on a strong base, etc., and securely fix it.
  • ・Do not use the Lift Master outside of its specifications. Failure to do so may result in electrical shock, injury or damage the lifter.
  • ・When installing the Lift Master, please comply with the relevant laws and regulations.
  • ・Refer to the installation procedure below, and take all necessary safety precautions.

2. Installation

(1) Please check in advance that the mounting surface is sufficiently rigid and that it is level with a spirit level.

※Ensuring that the mounting surface is level will make it easier to ensure the standing accuracy of the Lift Master.

Warning
  • ・Do not anchor directly to the concrete surface using the Lift Master mounting holes (4-Φ18).
    The product may topple over, resulting in a serious accident.
  • ・For anchor bolt fixation, please check the strength of your installation floor surface and select the installation base size, anchor mounting pitch, and size so that the anchor mounting portion will remain strong enough even when subjected to maximum load, maximum moment, and seismic load.
    ※If, for some reason, it is necessary to directly fix the product to a concrete surface, please install a separate anti-toppling measure.

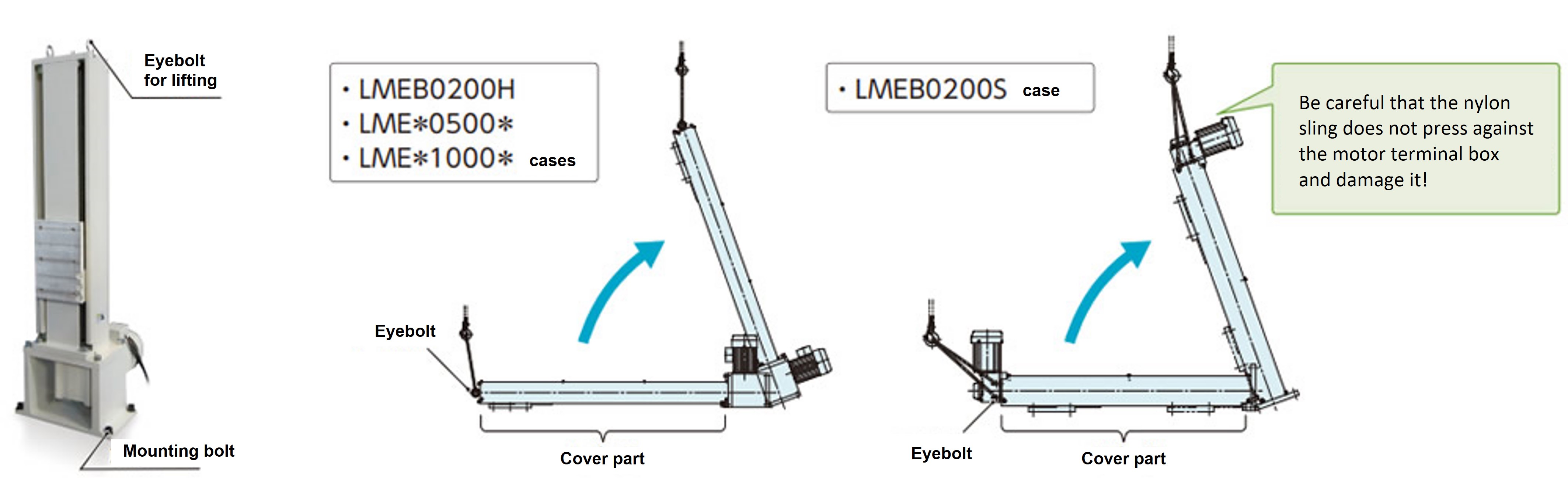

(2) When lifting the main unit, first disassemble the packing box, then hang a nylon sling or other lifting device on the eyebolts at the top of the main unit and stand the main unit up.

Lift the main unit while it is still standing and move it to the installation position.

※When lifting the unit, verify the weight noted in the delivery diagrams, and use an appropriate lifting device.

The diagram below is for reference only. Please refer to the delivery diagram for the actual dimensions.

Warning
  • ・When lifting the main unit, be sure to use the eyebolts on the top of the main unit.
    Since the center of the main unit has a hollow structure, hanging this part may damage the built-in equipment and lead to a serious accident.
Be careful that the nylon sling does not press against the motor terminal box and damage it!

(3) Temporarily fix the main unit of LIFT MASTER with four M16 bolts (strength grade 10.9 or higher).
*Mounting bolts to be prepared by the customer.

Warning
  • ・Installation of the Lift Master should be bolted to a sufficiently rigid steel plate, steel frame, or other mounting base.
    Use four M16 (strength grade 10.9 or higher) Lift Master mounting bolts with a thread length of 25 mm or more.

(4) Adjust the unit as necessary to make it level.

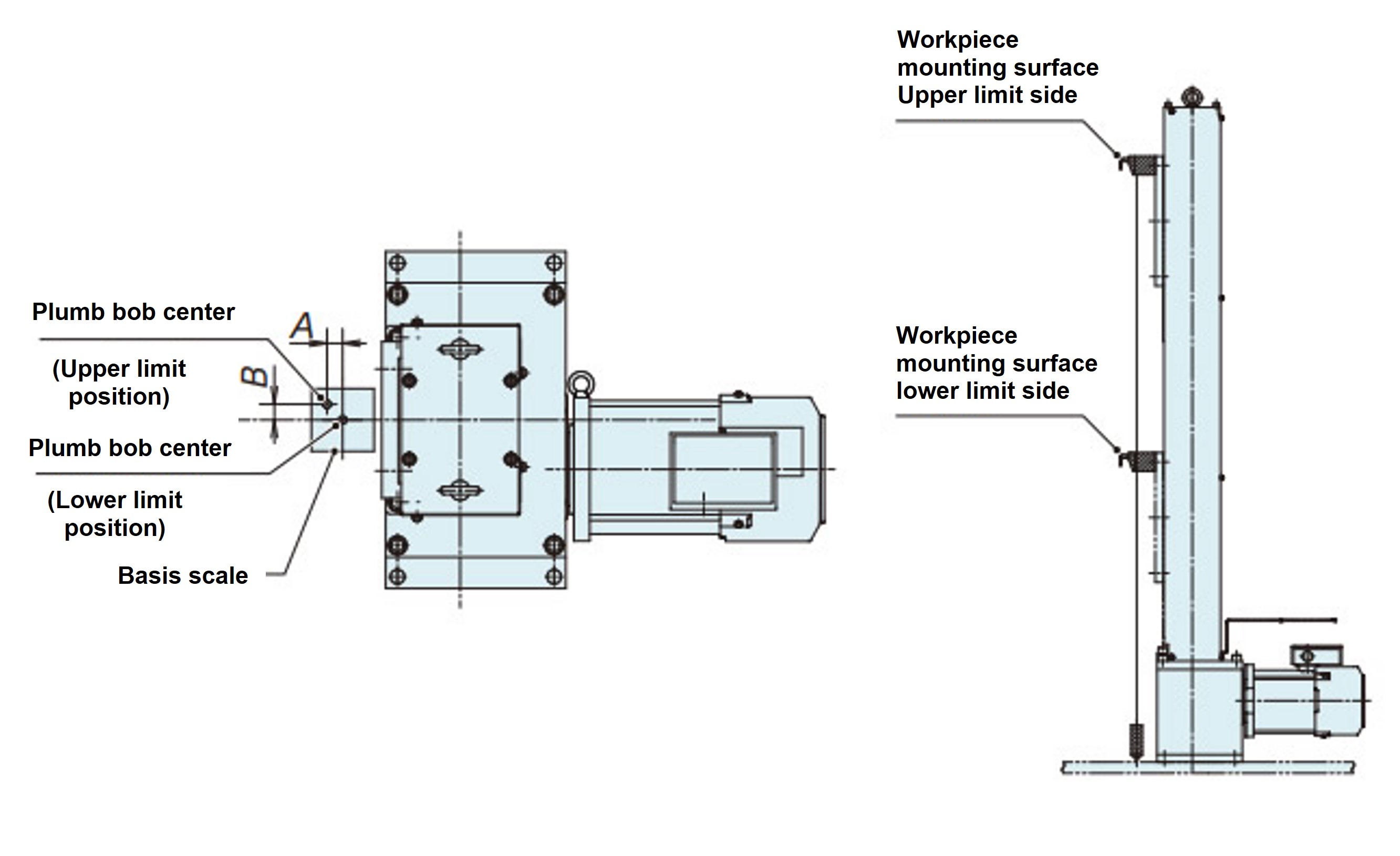

※To check the standing accuracy of the Lift Master, use a plumb bob, etc. as shown in the figure on the right.
(Make adjustments so that the error in dimensions A / B are within ±1mm (approx.) at the upper and lower limits of the Lift Master. )

(5) After adjusting the level, tighten the mounting bolts. (Recommended tightening torque 289N・m)

(6) Check for any issues in the mounting bolt tightening condition before performing trial operation.

[Image of plumb bob ]

Image of plumb bob
